What Looked Like a Straightforward Reroof Revealed More Underneath

Full Roof Replacement in Stoneham, MA

This Stoneham roof showed clear signs of age, but the biggest challenge was not visible until the old shingles were removed.

See how the project changed once the crew uncovered three roofing layers and deteriorated roof boards.

PROJECT
SNAPSHOT
Location
Stoneham, MA
Service
Full Architectural Shingle Roof Replacement
Property Type
Single-Family Home
Primary Concern
Aging roof with worn shingles and unreliable flashing details.
Key Findings
Weathered shingles, organic growth, lifting areas, improperly repaired chimney flashing, and a pipe penetration covered with roofing cement.
Solution
Complete reroof with a GAF roofing system, corrected flashing details, upgraded roof protection, and replacement of concealed deteriorated roof boards discovered during tear-off.

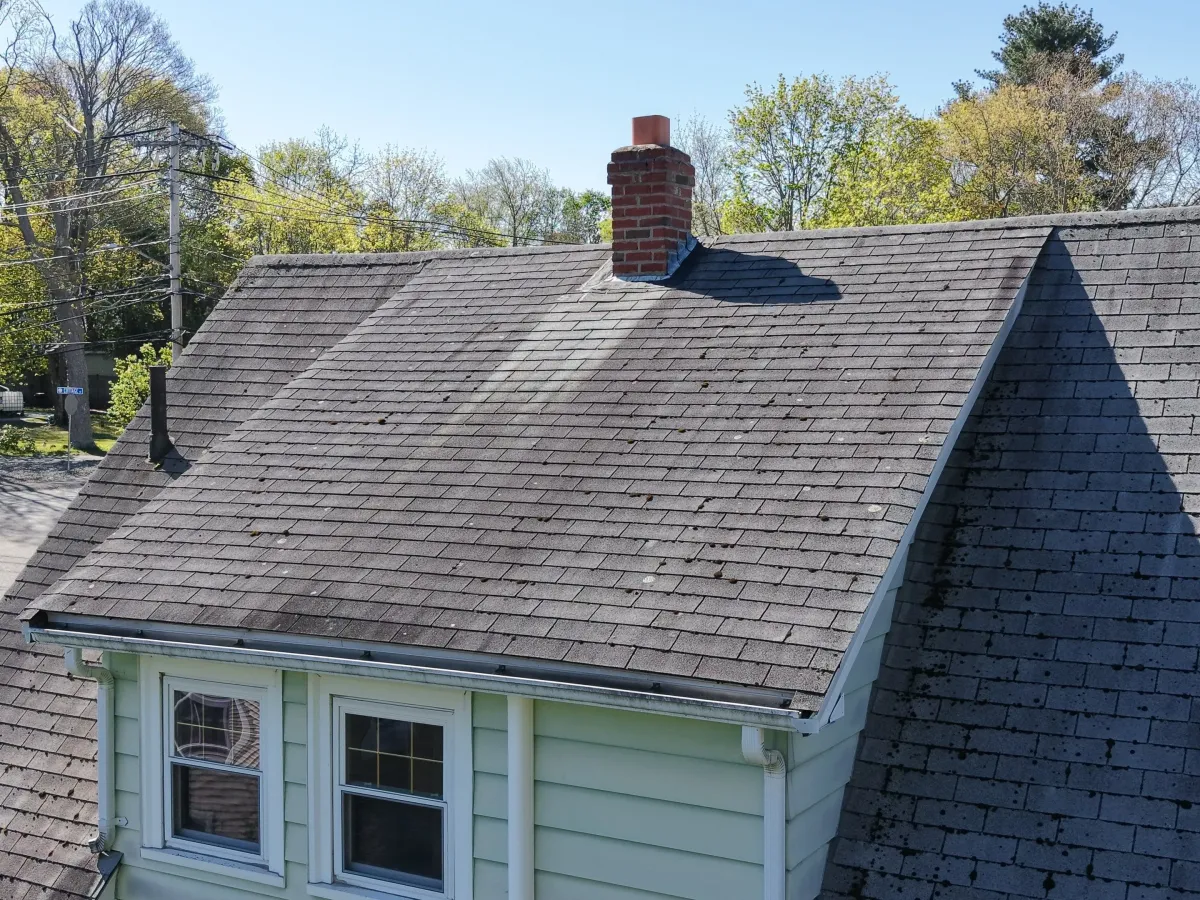

The Roof Had Reached the Point Where Repairs Were No Longer Enough

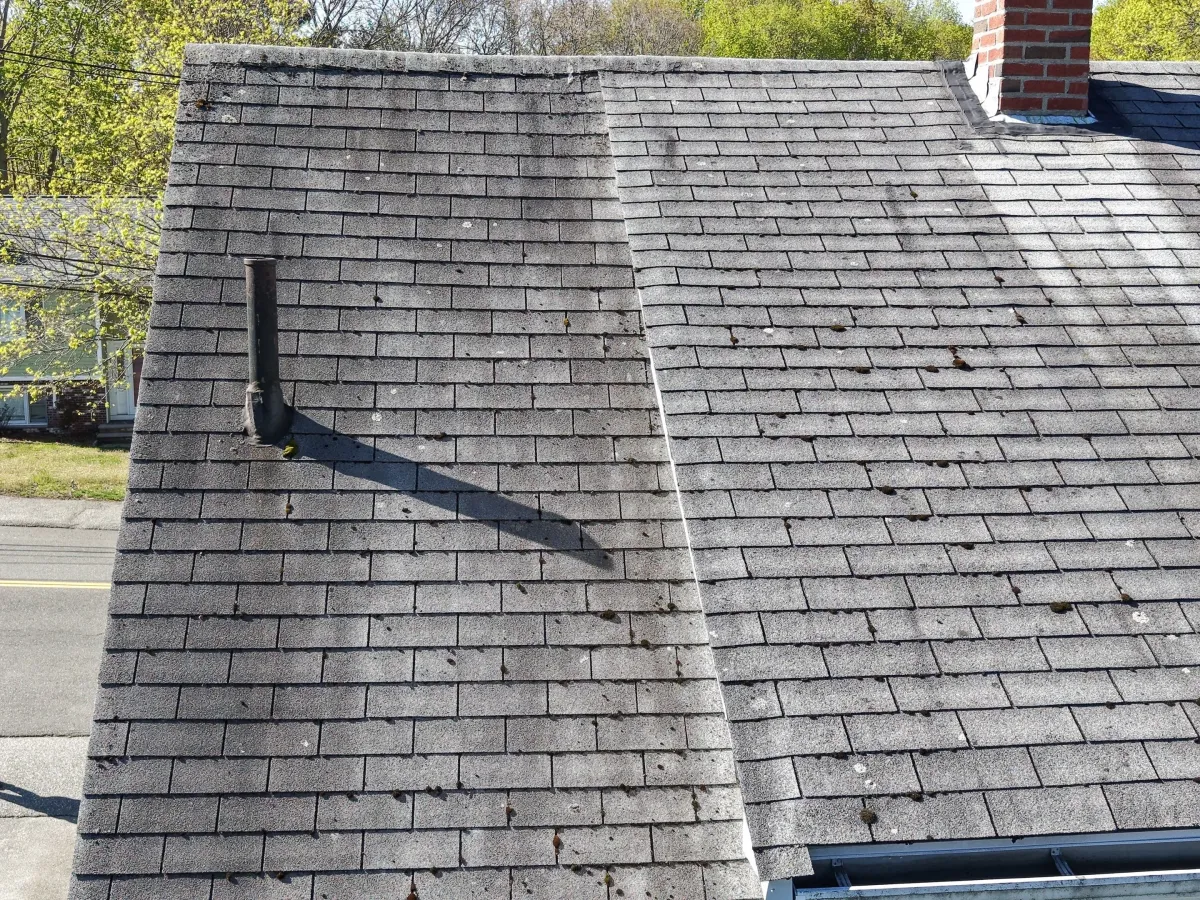

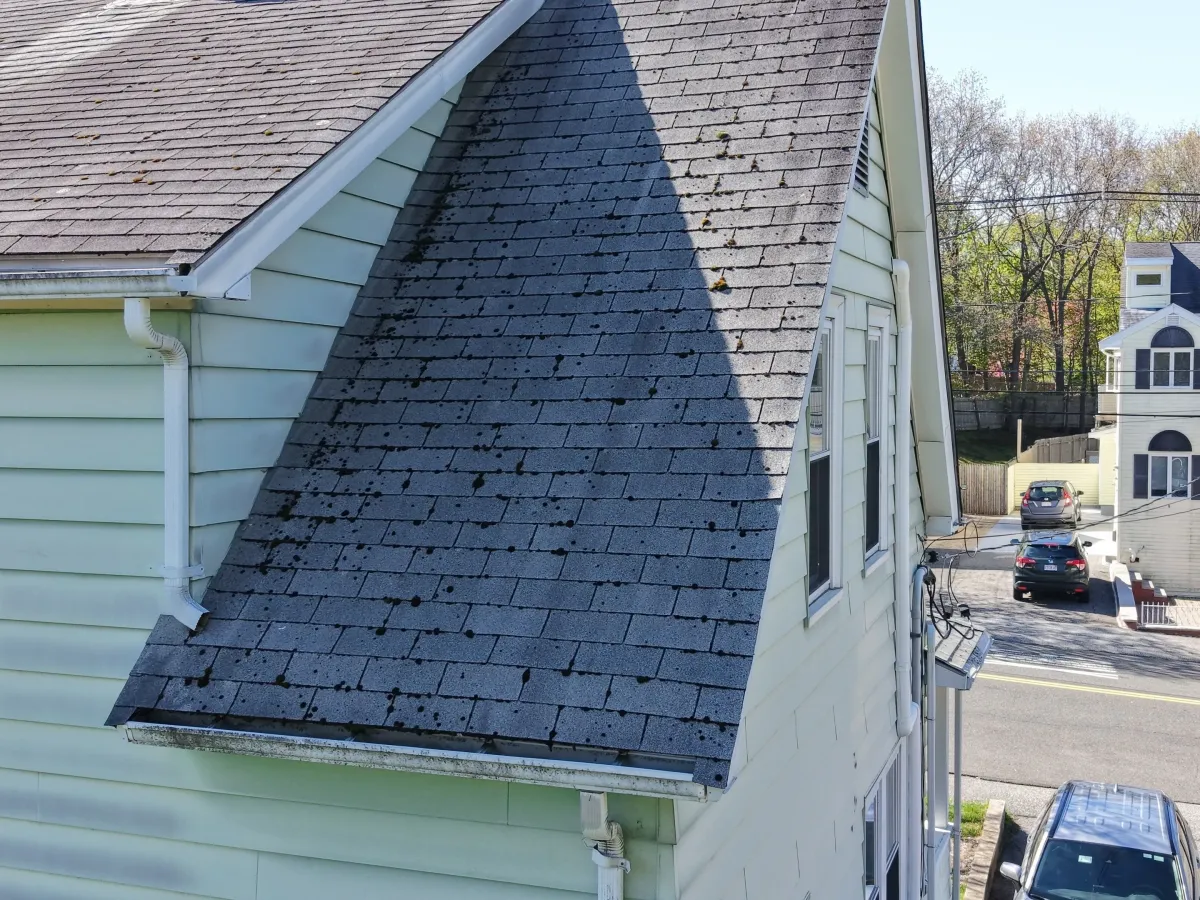

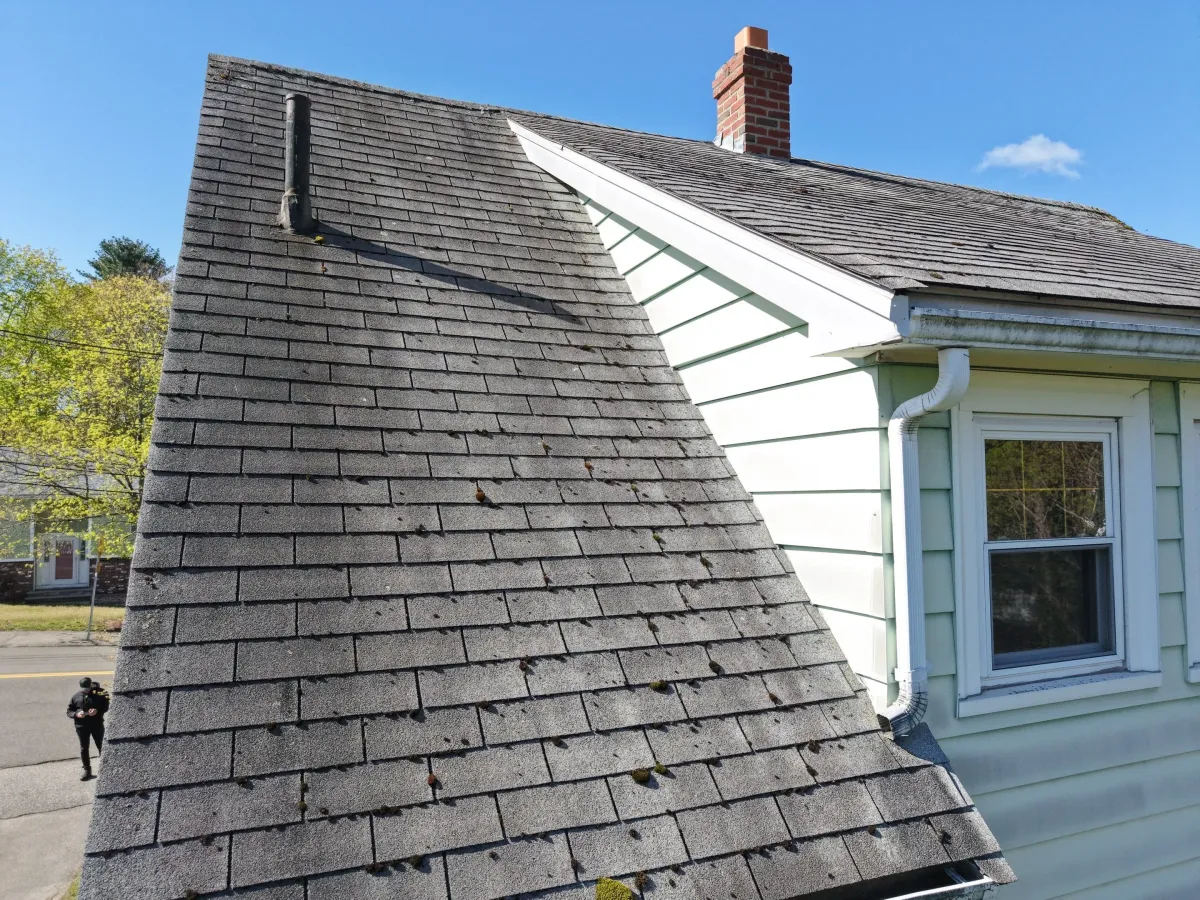

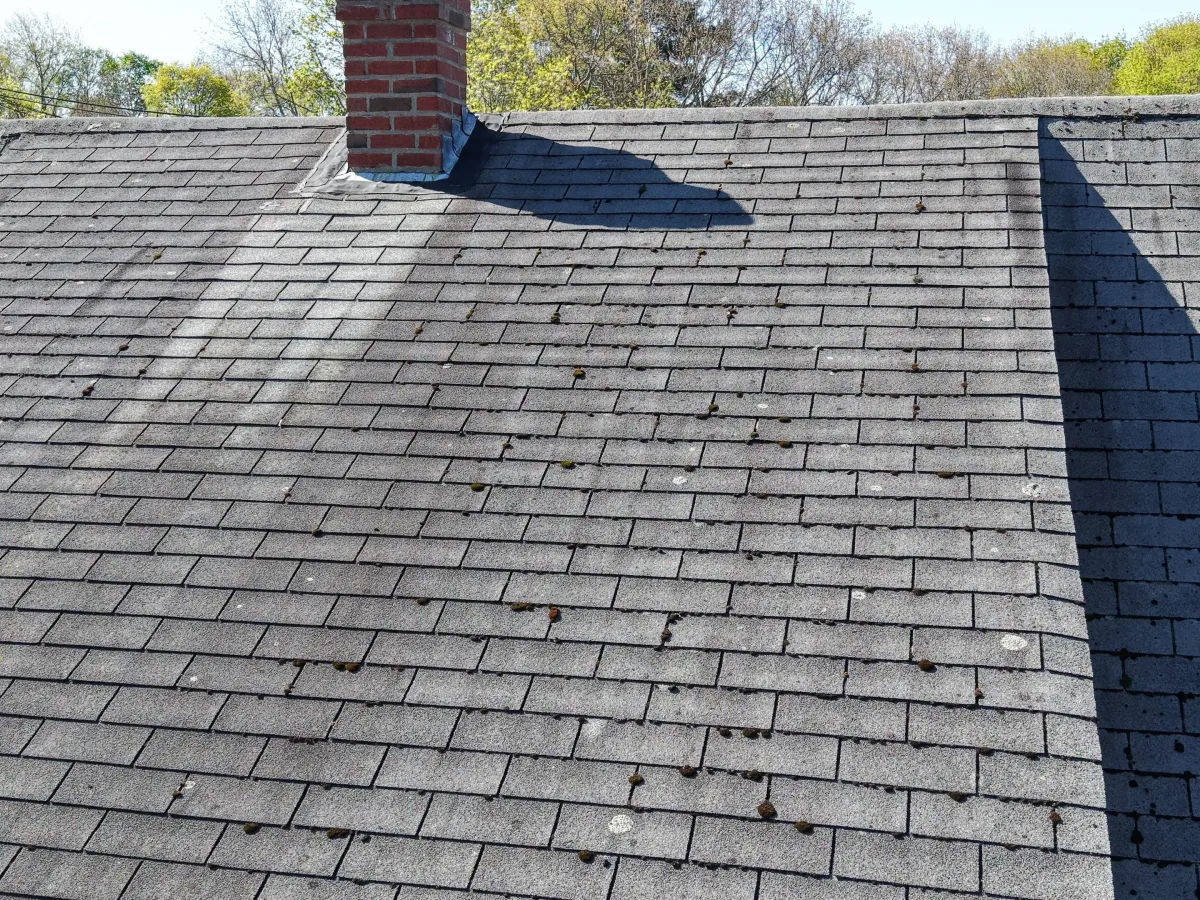

The main roof showed widespread age-related wear. Several areas had discoloration, organic growth, lifting shingles, and uneven courses that indicated the system was nearing the end of its serviceable life.

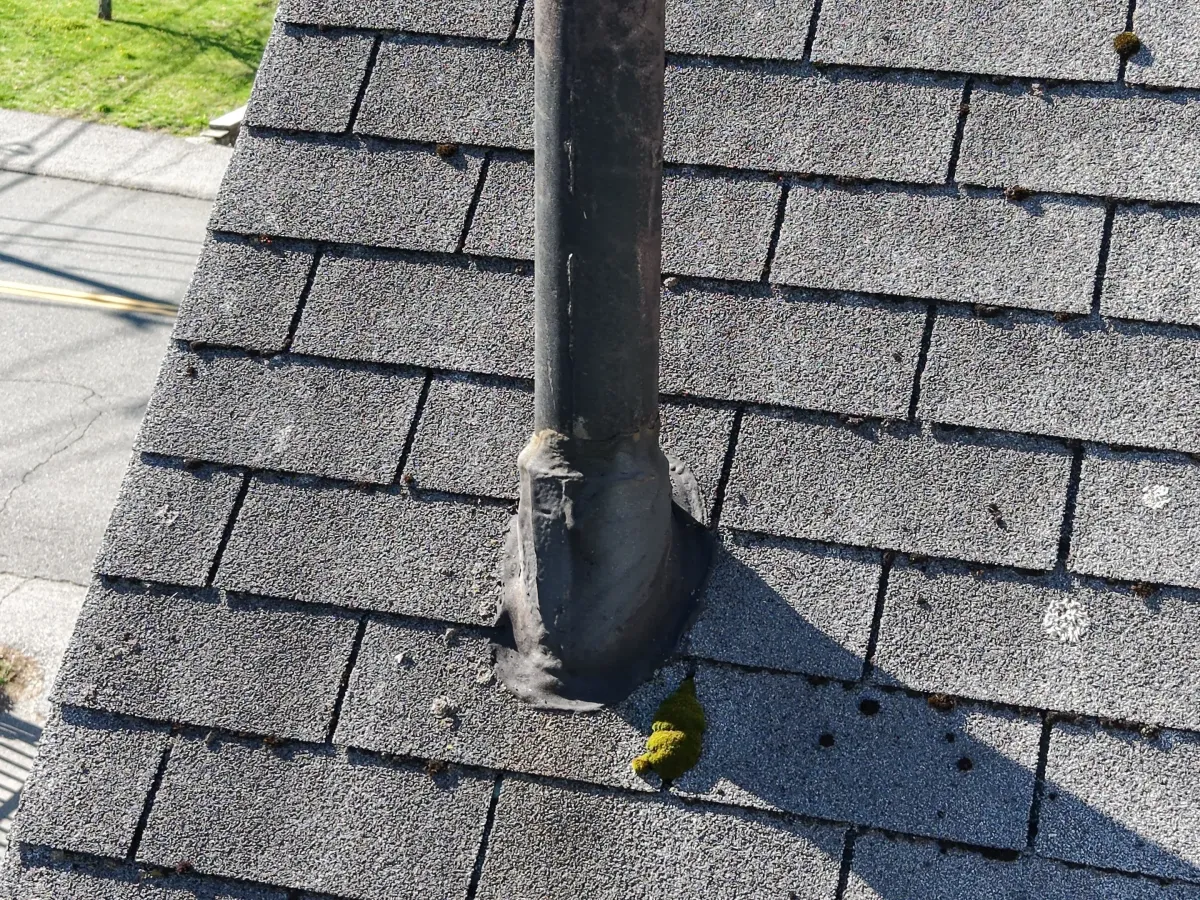

The flashing details also raised concern. The chimney had been surrounded with rubberized repair tape, while the pipe penetration appeared to have been covered with roofing cement. Both conditions suggested temporary repairs rather than dependable long-term protection.

With the wear spread across the roof, replacing the system made more sense than continuing to patch isolated areas.

The Homeowner Wanted More Than the Lowest Price

The homeowner was comparing several roofing proposals and wanted to understand what separated one contractor from another.

Price mattered, but so did the workmanship warranty, the roofing system being installed, and how the property would be protected during construction. Cleanup was especially important after the homeowner heard about another project where nails and debris were left behind.

We responded by putting the warranty, roofing components, property protection, and cleanup process clearly in writing. That transparency helped the homeowner compare the proposals based on the full value of the work, not only the initial price.

Tear-Off Revealed Conditions the Inspection Could Not See

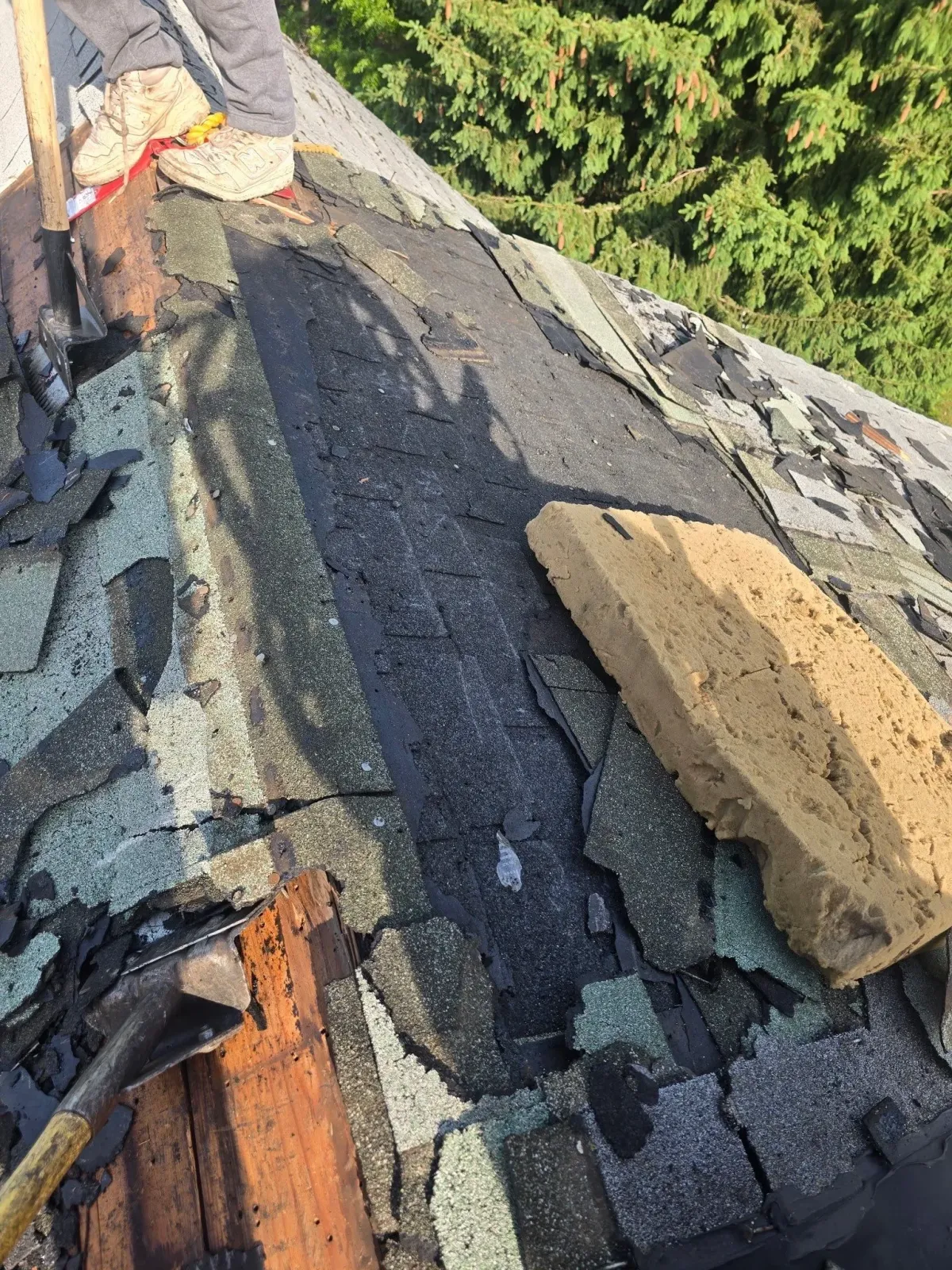

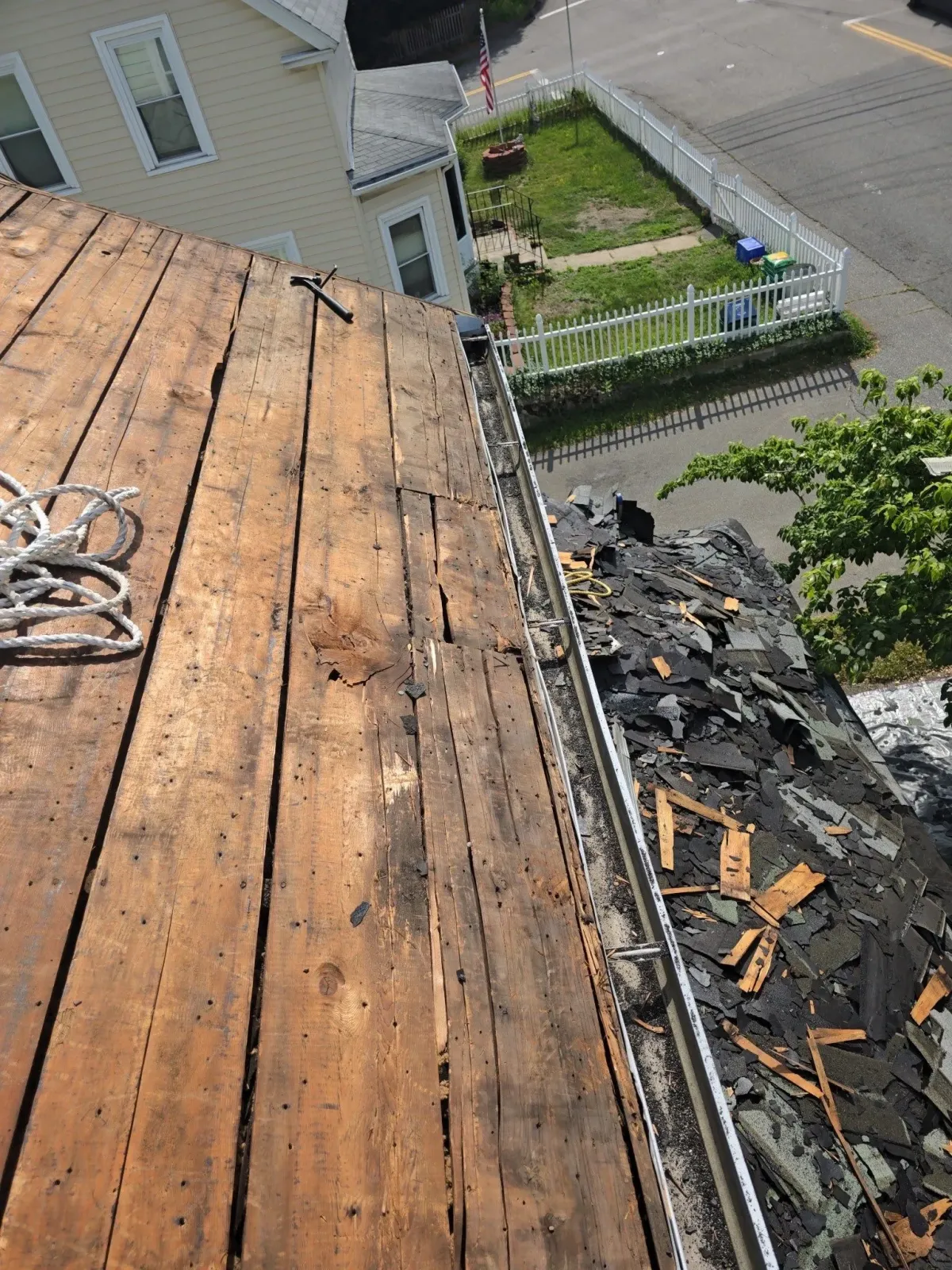

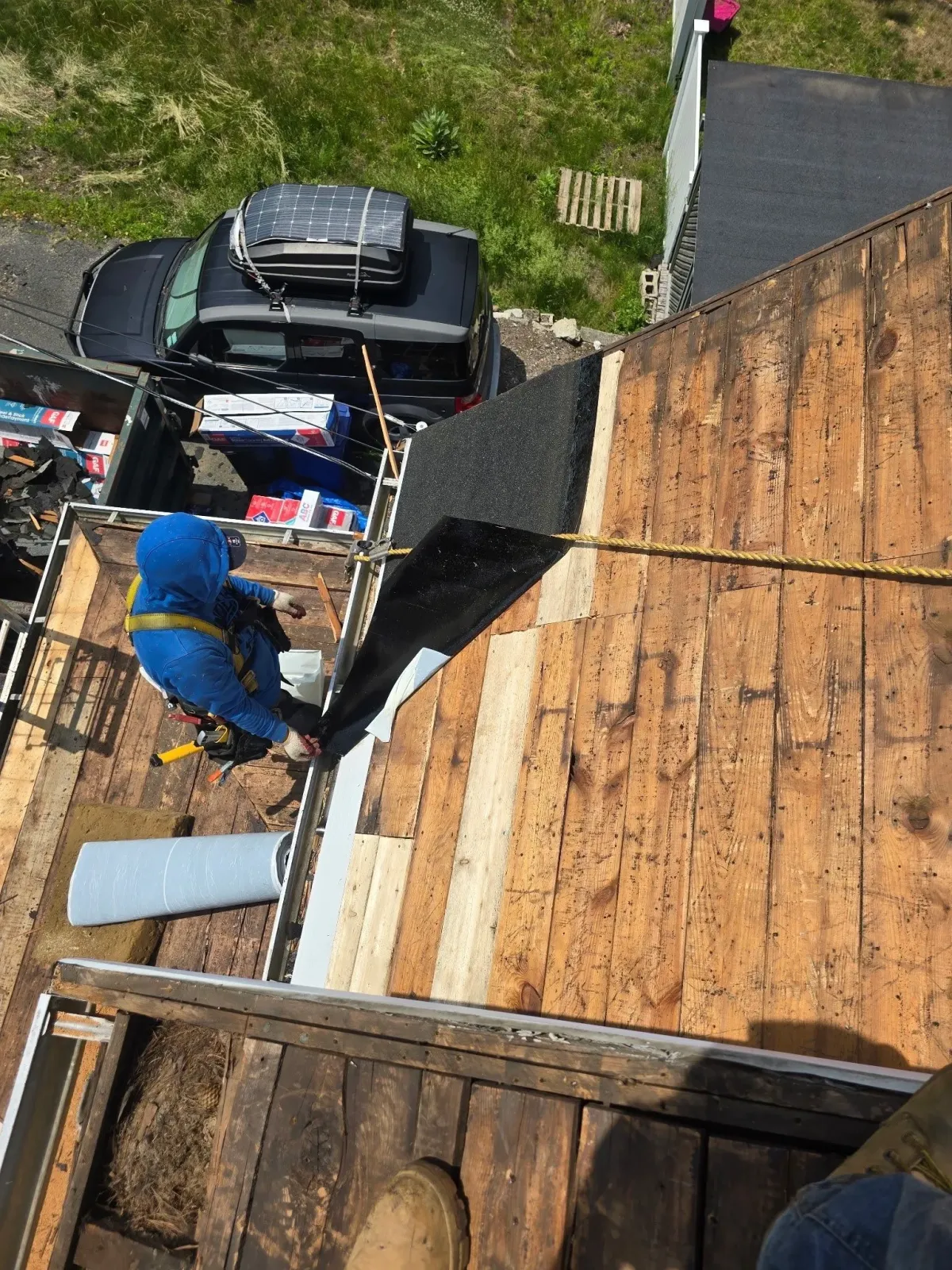

Once the existing roof was removed, the crew discovered three layers of shingles rather than the single visible roofing layer anticipated before construction.

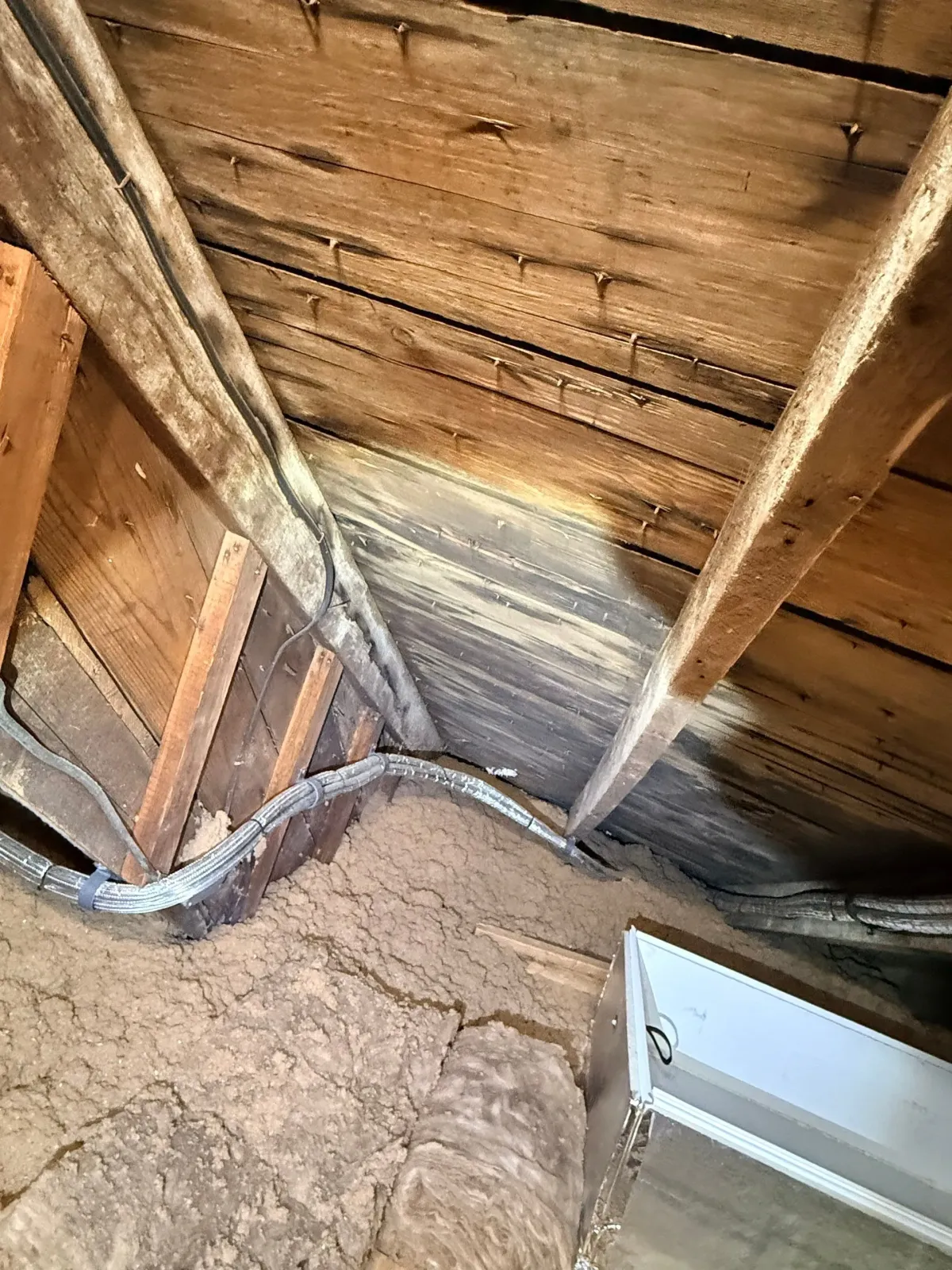

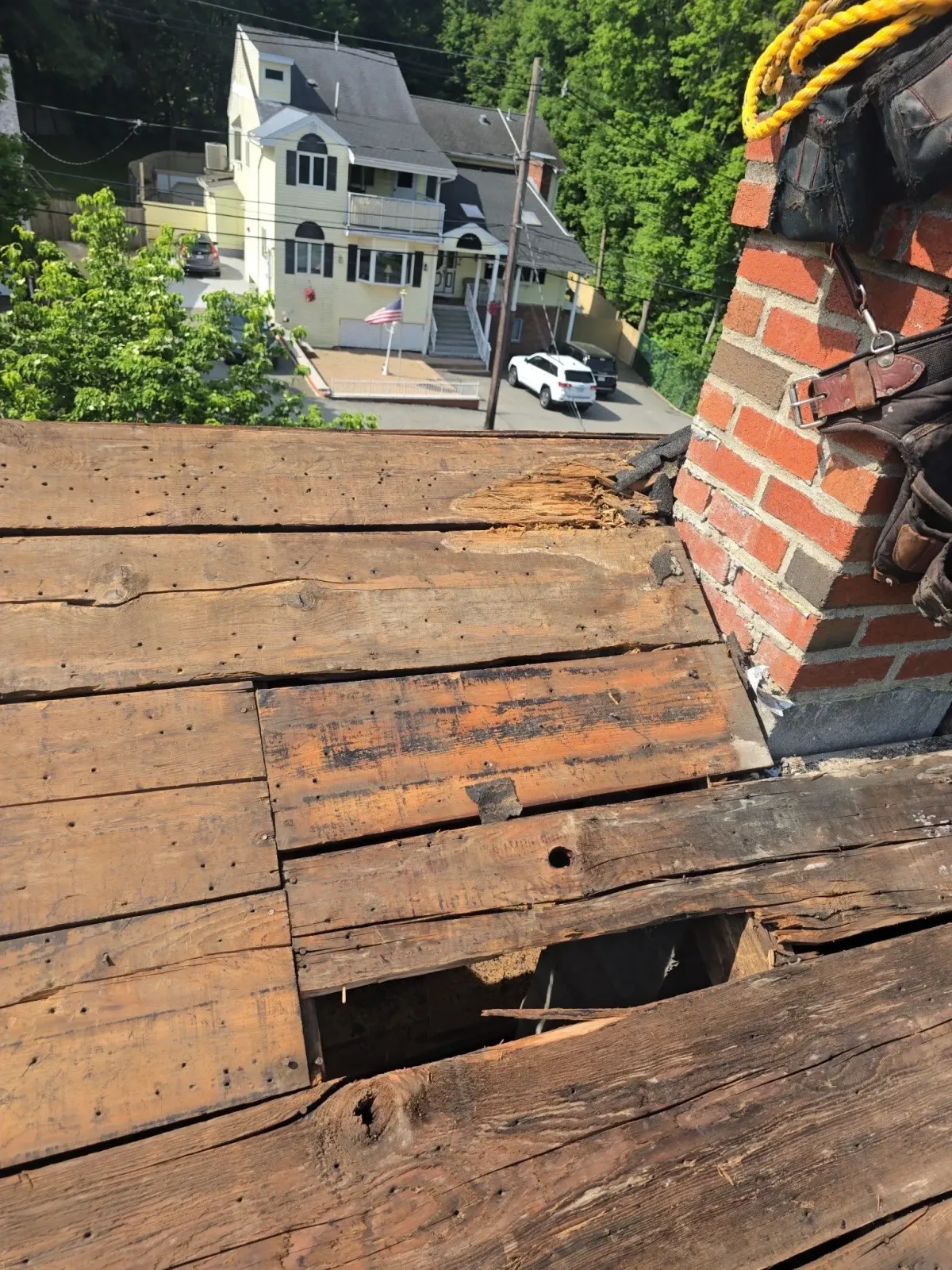

The original board decking also contained large gaps and deteriorated sections. These conditions were concealed beneath the roofing materials and could not be fully confirmed during the exterior inspection.

Installing a new roof directly over that surface would not have provided the stable, reliable base the new roofing system required. The findings were documented with photos, explained to the homeowner, and handled through an approved change order before the additional work moved forward.

Full roof replacement
Full roof replacement
Full Roof Replacement

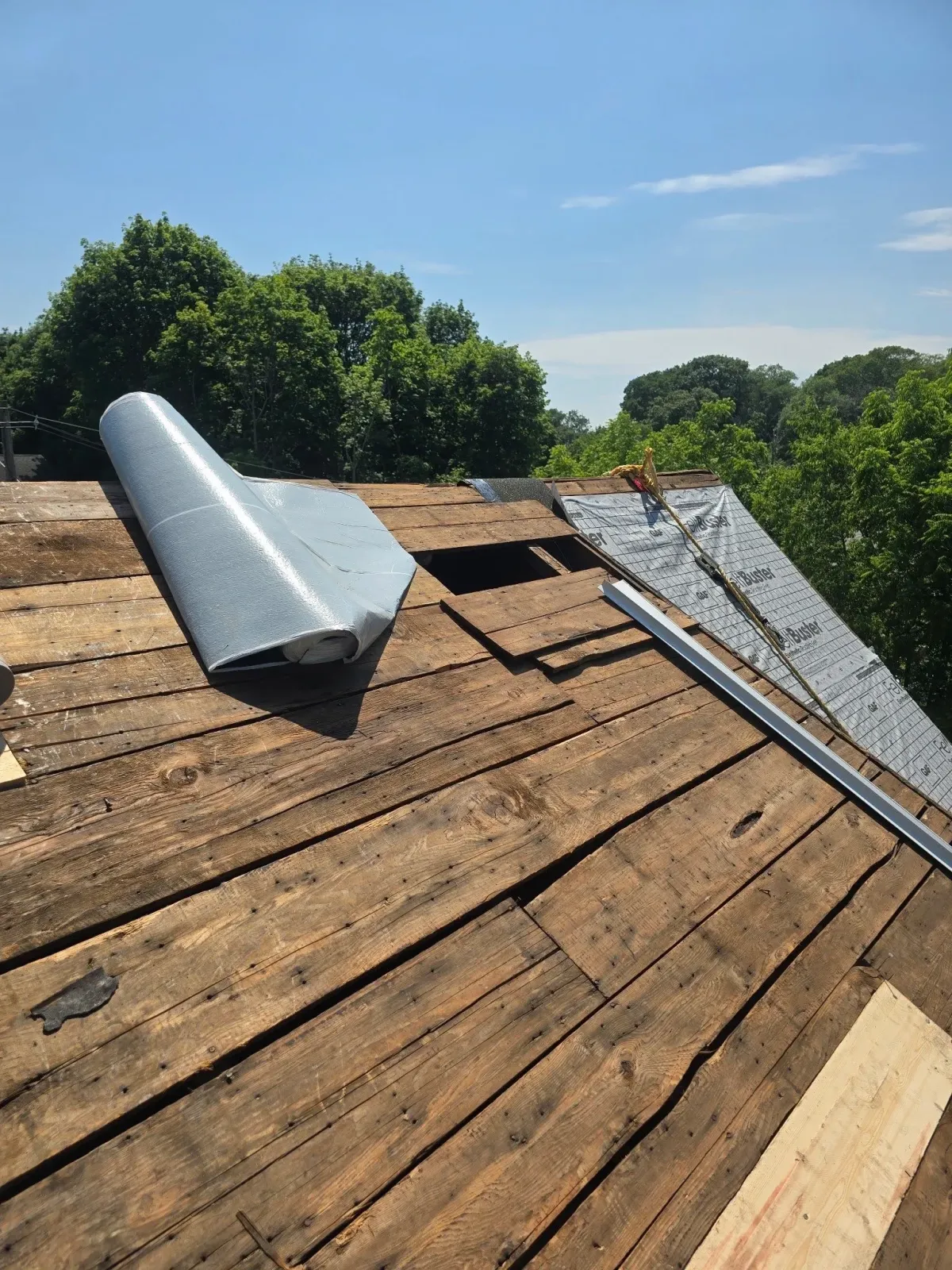

Roof decking after corrective work

Why Correcting the Decking Mattered

A new roof can only perform as well as the surface beneath it.

The gaps and damaged boards created an uneven base that could interfere with fastening and leave portions of the roof without dependable support. Correcting those conditions gave the new underlayment and shingles a stronger foundation.

The additional work was not simply an upgrade. It was necessary preparation to install the new system correctly and avoid covering hidden weaknesses with new materials.

Before / After Slider
After
Before
Before After

Roof Replacement — Stoneham, MA

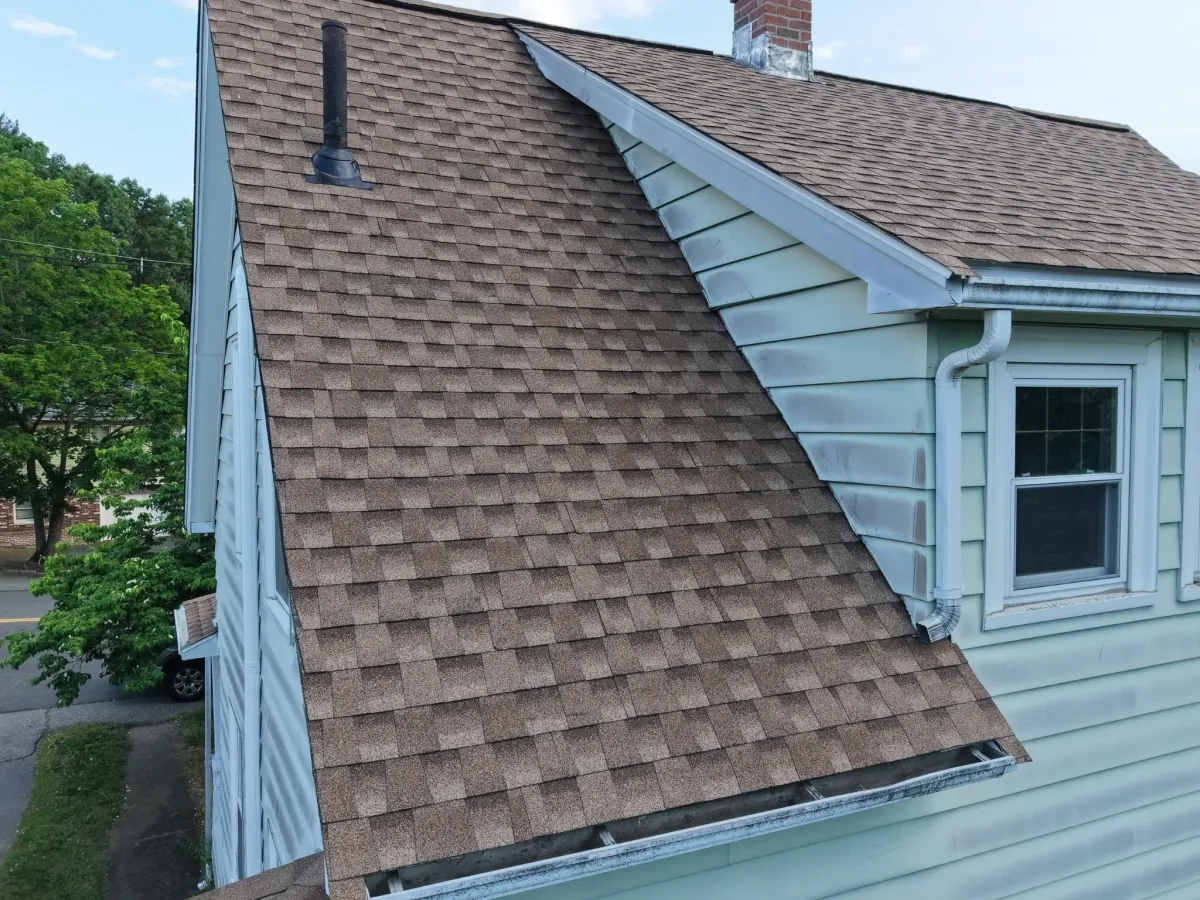

Aging roof replaced with a full GAF system.

Drag the slider to compare

The Improvements Were Tied Directly to What We Found

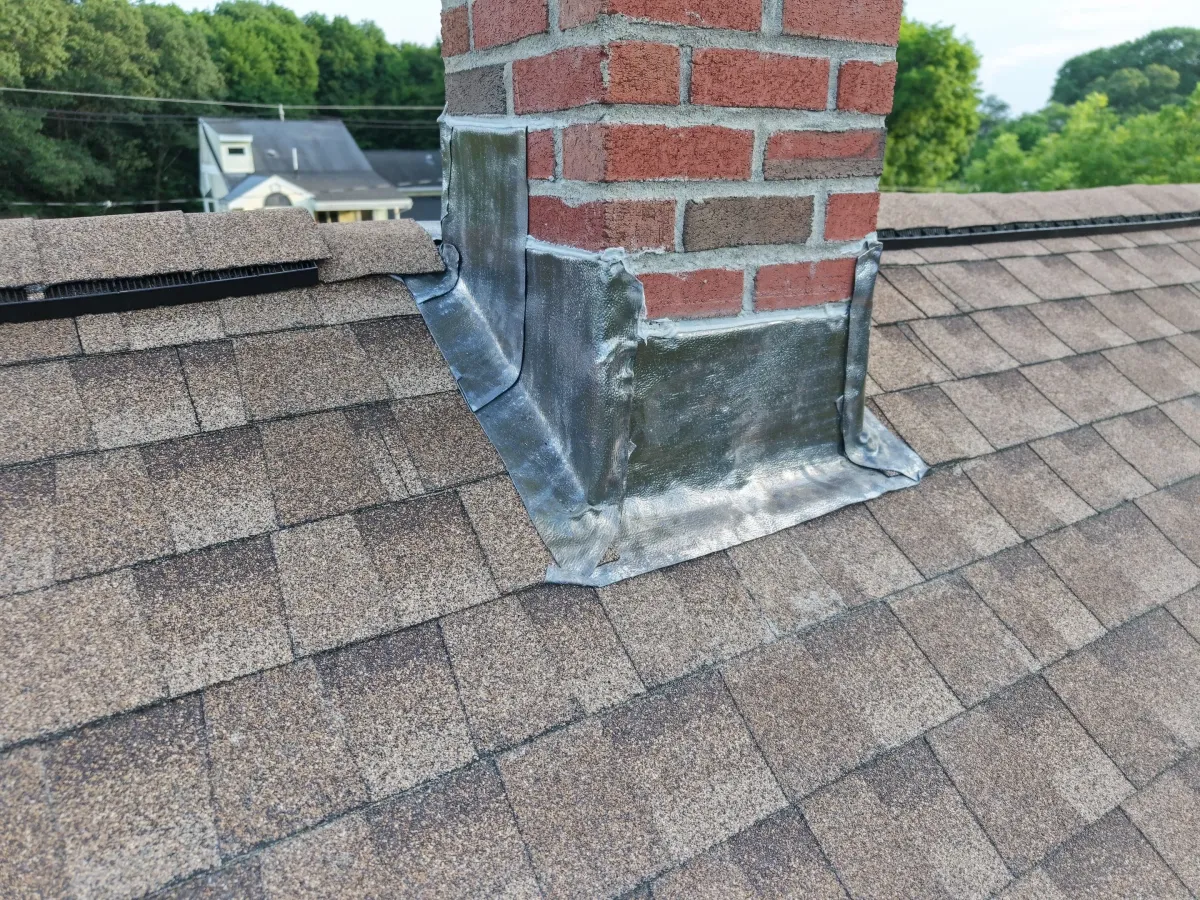

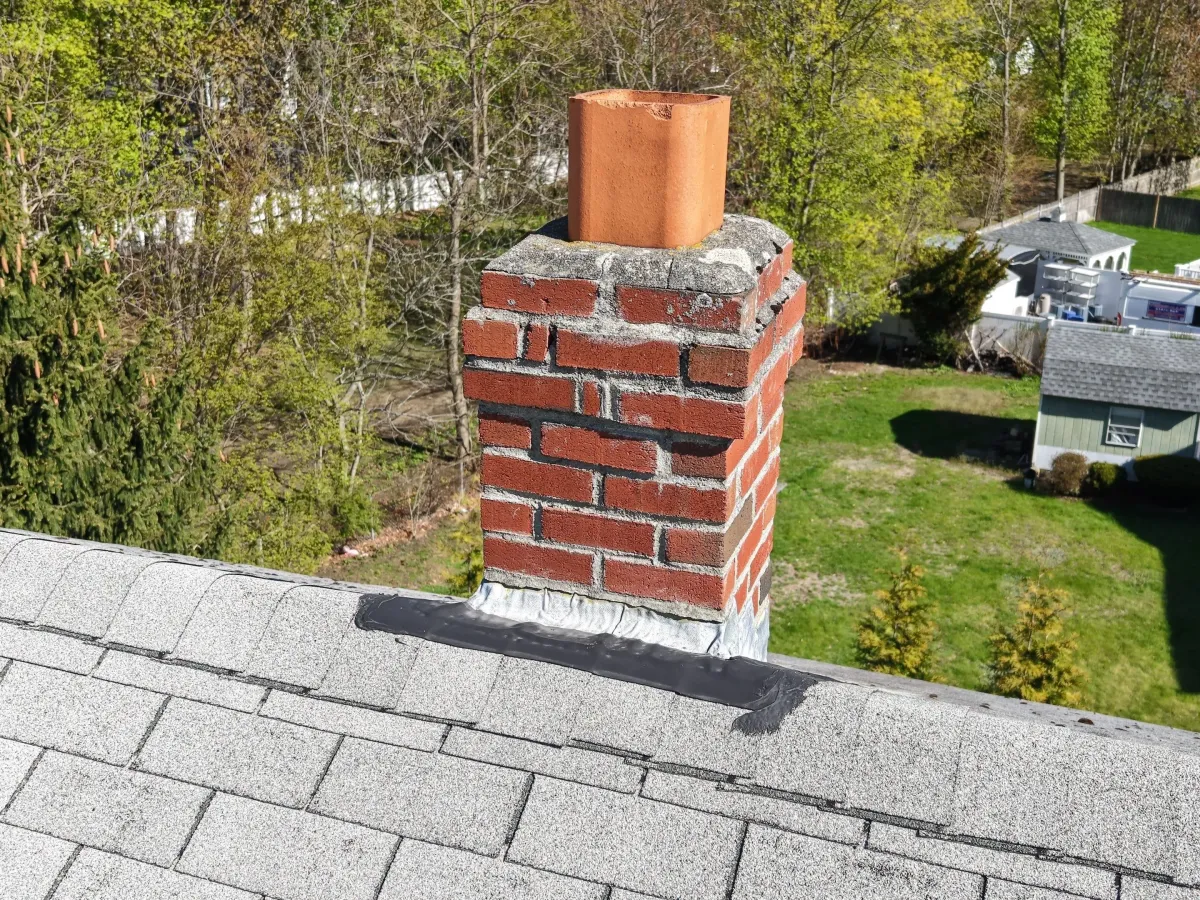

Proper chimney flashing integrated with the new roof

Temporary chimney repairs were replaced with proper flashing.

The existing chimney had been surrounded with rubberized repair materials. During the reroof, the flashing could be integrated properly with the new roofing system instead of relying on another surface patch.

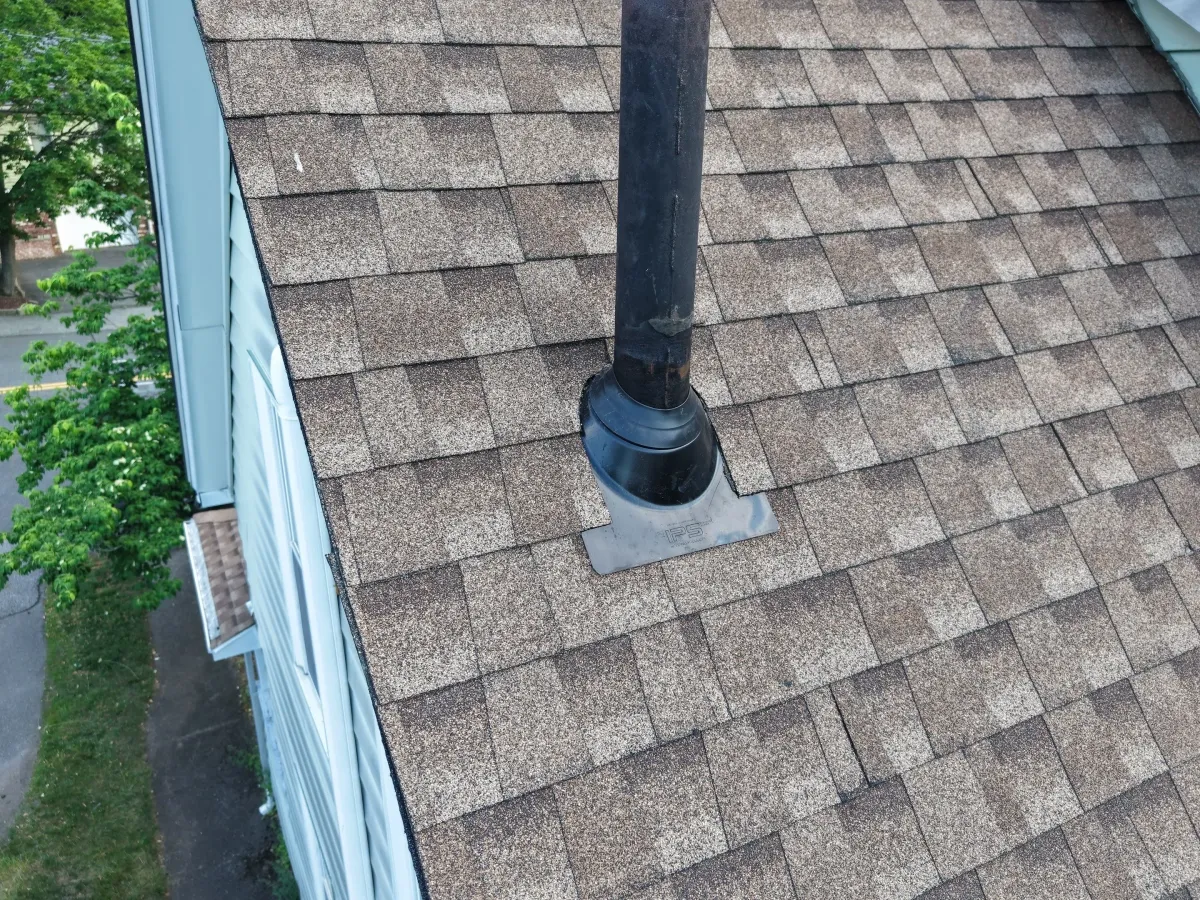

Pipe penetration rebuilt during the reroof

The pipe penetration was rebuilt as part of the new system.

The previous area had been covered with roofing cement. Reworking the penetration during the reroof provided a cleaner and more dependable waterproofing detail.

Roof decking repaired before new materials were installed

The roof received a stronger installation base.

The concealed gaps and deteriorated boards were corrected before the new materials were installed, giving the roofing system proper support.

Roofing crew protecting and cleaning the property

Cleanup expectations were established before work began.

Protection, debris control, magnetic nail cleanup, and a final walkthrough were clearly included so the homeowner knew how the property would be handled throughout the project.

What the New Roof Was Installed Over

The most important part of this project was not visible from the ground after completion.

The construction photos show why tear-off and deck inspection matter. Removing the old roof exposed the extra shingle layers, open board gaps, and deteriorated sections that needed to be corrected before the new system could be installed properly.

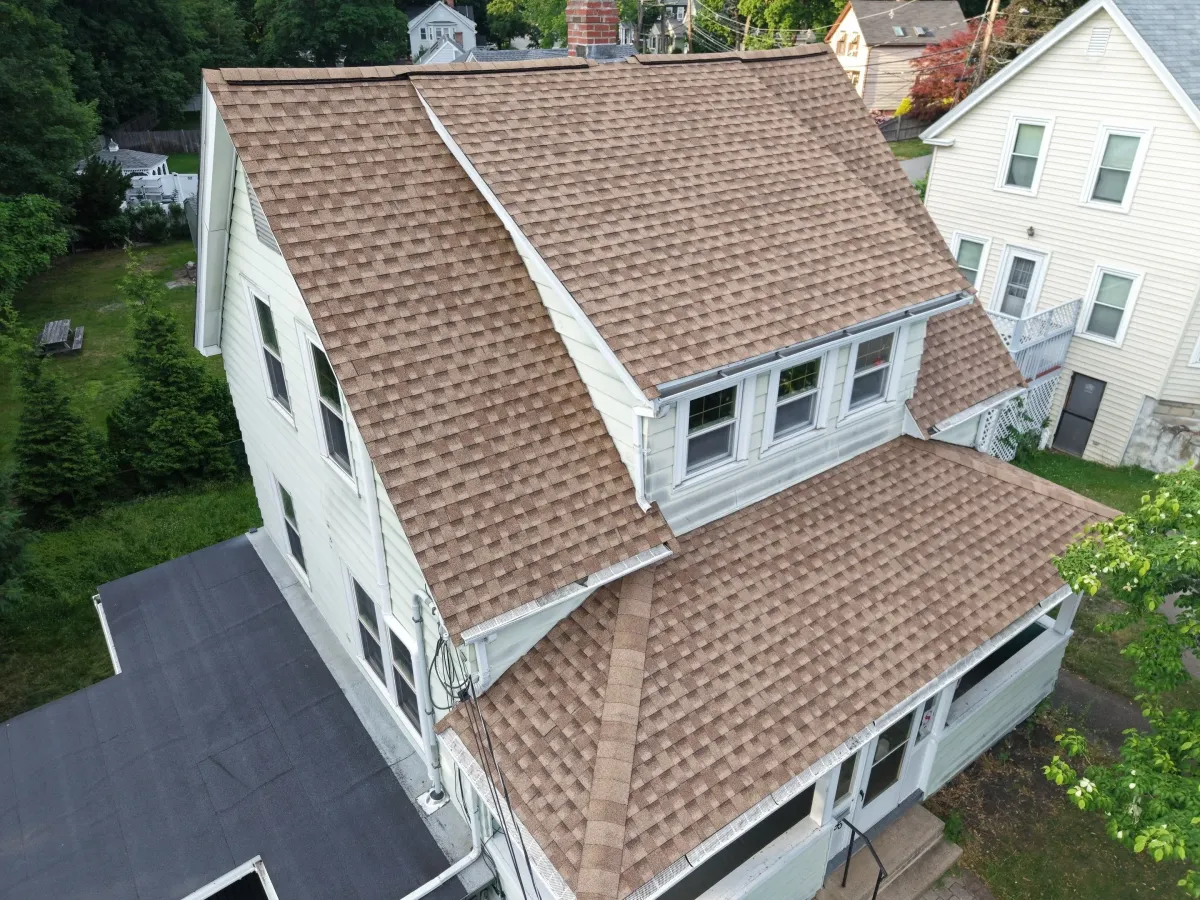

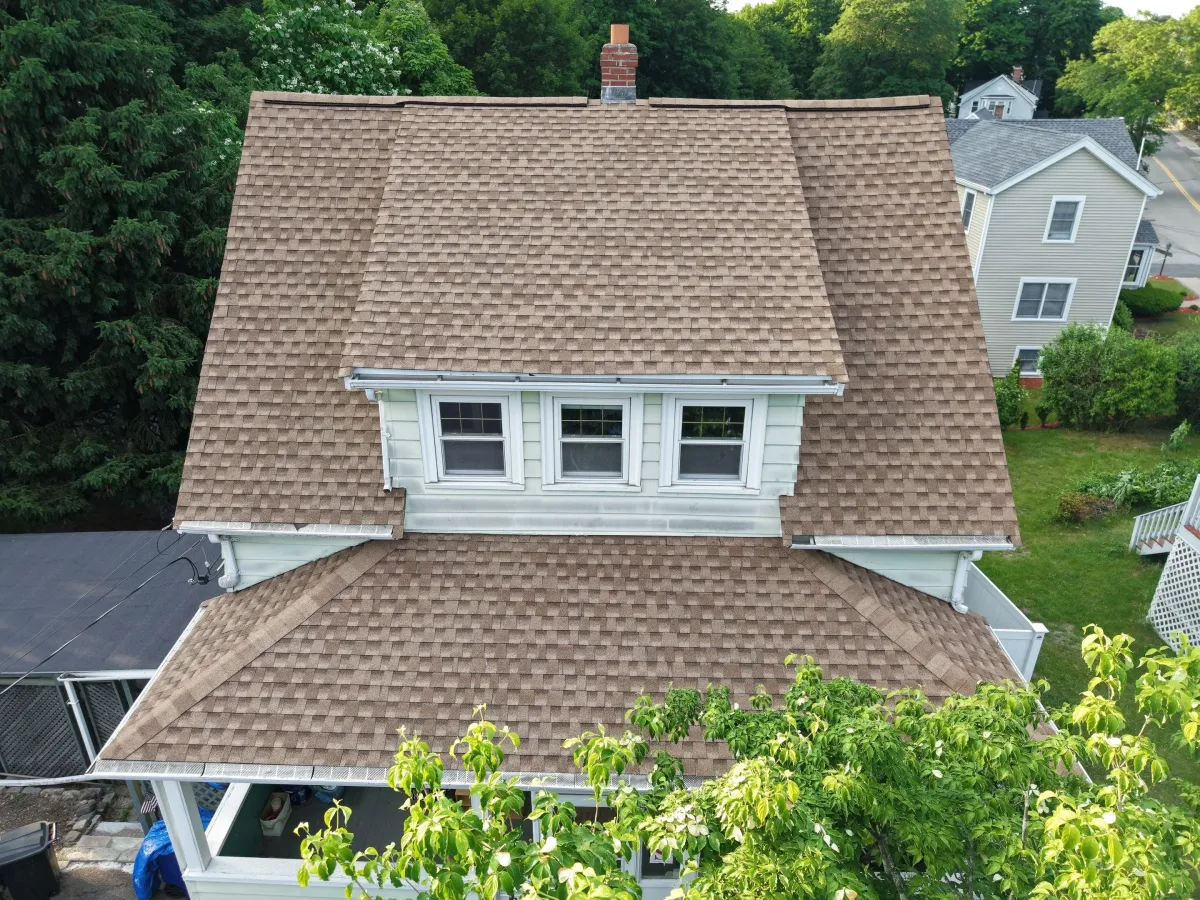

The Finished Result

The completed project gave the home more than a cleaner-looking roof.

The aging shingles and temporary repair details were removed, the concealed roof-board conditions were corrected, and the new GAF roofing system was installed over a properly prepared surface.

Just as importantly, the homeowner received the clarity they were looking for: documented findings, written expectations, a defined cleanup process, and a roofing system built for dependable long-term performance.

Clear communication throughout.

Amazing service from Peak Roofing. From the initial contact, to discussing the project, to the estimate, everything was communicated clearly and professionally. Jim did a great job managing this relatively small project.

John Gallagher

Stoneham, MA, USA
38 Summer St, Lynnfield, MA 01940, USA

Not Sure What May Be Hidden Beneath Your Roof?

An exterior inspection can show visible wear, but some conditions cannot be confirmed until the existing materials are removed.

Peak Quality Roofing documents what we find, explains why it matters, and reviews any change with you before additional work moves forward.

Roof Replacement FAQs for This Stoneham, MA Project

Why can’t every decking problem be identified before tear-off?

The existing shingles and underlayment cover the roof deck. While some warning signs may be visible from the attic or exterior, concealed gaps, deterioration, and extra roofing layers may not be fully confirmed until removal begins.

Why did the additional shingle layers require a change order?

Removing multiple layers requires additional labor, disposal, and handling beyond a standard single-layer tear-off. The added work is documented and reviewed with the homeowner before proceeding.

Why is deteriorated board decking replaced during a reroof?

The roof deck must provide a solid fastening surface for the new system. Damaged boards or large gaps can prevent proper attachment and reduce the reliability of the finished roof.

What cleanup should be expected after roof replacement?

The work area should be cleared of roofing debris, surrounding surfaces should be inspected, and magnetic sweeps should be completed to collect nails and metal debris. A final walkthrough helps confirm the property has been left in acceptable condition.

Do you provide full roof replacement in Stoneham, MA?

Yes. Peak Quality Roofing provides roof inspections, full roof replacement, flashing work, ventilation improvements, and related exterior services in Stoneham and nearby Greater Boston communities.

We provide honest roof inspections and clear reports so you can make confident decisions about your home.

FOLLOW US ON

OFFICE LOCATION

58 Mount Vernon Ave, Melrose, MA 02176

58 Mt Vernon Ave, Melrose, MA 02176, USA

Copyright 2025. All rights reserved. Website by Pure Value Advisors
